Prime Contractor vs Subcontractor

Prime Contractor vs Subcontractor: The Difference That Actually Matters

A prime contractor holds the contract with the government. A subcontractor holds a contract with the prime contractor. Every other difference between the two paths, margin, risk, past performance, compliance burden and how fast you get paid, follows from that one structural fact.

Here is a detail that says a lot about how the acquisition system is built. FAR 44.101 defines a subcontractor precisely, as “any supplier, distributor, vendor, or firm that furnishes supplies or services to or for a prime contractor or another subcontractor.” Search FAR 2.101 for a matching definition of prime contractor and there is not one. The regulation defines the subordinate role and assumes you already understand the senior one.

That asymmetry is not an accident. The government’s contractual relationship runs to the prime and stops there. The prime is the party that signed, the party that gets paid, the party that is evaluated, and the party that answers for every dollar and every clause below it.

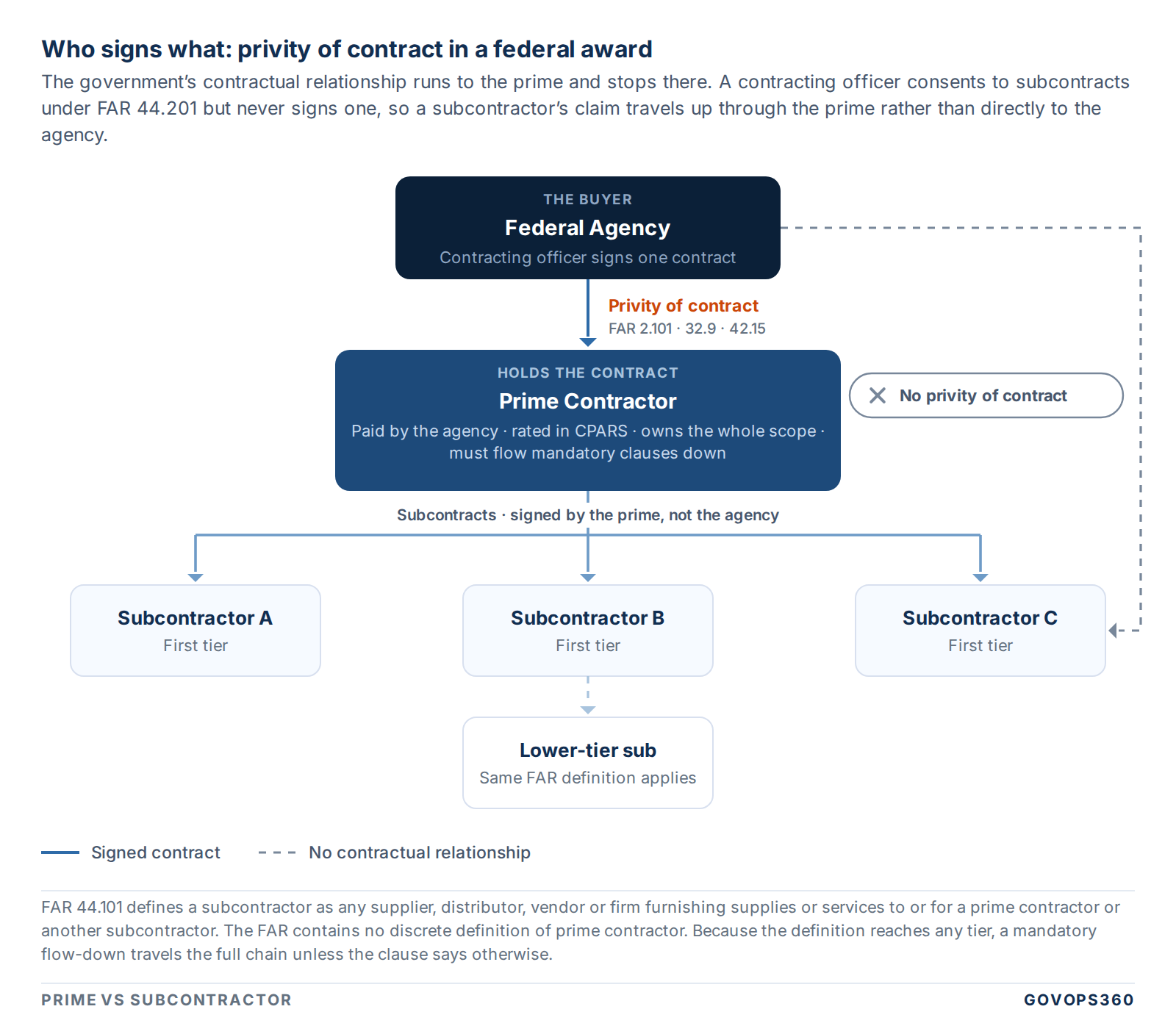

Diagram of privity of contract: a federal agency signs only with the prime contractor, which subcontracts to first-tier and lower-tier subs with no privity to the agency

What privity means on a Tuesday

A contracting officer consents to subcontracts under FAR 44.201 but never signs one. A subcontractor with a payment dispute sues the prime contractor, not the Treasury. And a subcontractor’s excellent work is recorded against the prime’s name.

Tiers, and why the FAR does not care about them

Industry talks about first-tier and lower-tier subcontractors. The FAR does not use those labels. Its single definition of subcontractor covers any firm supplying “a prime contractor or another subcontractor,” so the same rules reach down the chain regardless of depth. When a clause flows down, it flows all the way unless the clause says otherwise.

That matters when you are the sub. Being third tier does not exempt you from a mandatory flow-down. It only means the obligation reached you through two intermediaries who each had a duty to pass it on.

50%

The share of a services set-aside a small business prime must keep with itself or similarly situated firms (13 CFR 125.6)

$900K

Contract value above which a large prime must carry a small business subcontracting plan, $2M for construction (FAR 19.702)

Zero

CPARS records a subcontractor earns for subcontract work. The rating attaches to the contract holder

Side by Side: What Actually Changes

Most comparisons of these two roles list adjectives. The table below lists mechanisms, because every difference that matters traces to a specific regulation or a specific cash-flow consequence.

Prime contractor versus subcontractor across nine dimensions
DimensionAs prime contractorAs subcontractor
Contractual relationshipSigns with the government and holds privitySigns with the prime contractor, no privity with the government
Who pays youThe agency, 30 days after a proper invoice (FAR 32.904)The prime, on subcontract terms
Past performanceA CPARS record in your own nameNo CPARS record of your own
Revenue recognizedFull contract valueYour subcontract value only
Performance riskThe whole scope, including your subs’ failuresLimited to your scope of work
Compliance loadSubcontracting plan, ISR/SSR, CPSR, ICS, flow-down dutyWhatever flowed down to you
Set-aside limitsMust keep 50% of services, 15% of general constructionNot directly constrained
BondingMiller Act bonds over $150,000 on constructionOnly if the prime requires it
Agency relationshipDirect, and it compounds across recompetesMediated by the prime

How to read that table

Two rows do most of the work in a real decision.

The past performance row is the reason firms outgrow subcontracting. Every year spent as a sub builds capability and revenue, but not the one asset a source selection scores directly.

The compliance load row is the reason firms attempt priming too early. Each item in it is a real system that has to exist before award, not a form you complete afterwards.

The Prime-Readiness Scorecard

Ten questions. Each maps to a specific regulatory threshold or a specific way firms get hurt, not to general readiness. Answer honestly and the total tells you whether to prime this year, team this year, or fix something first.

Prime-Readiness Scorecard

Check every statement that is true of your firm today, not the version of your firm you expect at award.

0 of 10

Check the statements above to see your readiness band.

Reading your score

  • 8 to 10. You are built to prime. Pick pursuits where your past performance is genuinely relevant and bid them.
  • 5 to 7. Prime selectively, on smaller fixed-price work that does not trigger the systems you are missing. Team on anything cost-reimbursement.
  • Below 5. Subcontract deliberately this year and close the gaps. Bidding prime without an adequate accounting system or the working capital to finance a payment lag is how firms win work that then damages them.

Two of the ten are disqualifying rather than scored. Without SAM registration you cannot be awarded a prime contract. And if a single subcontractor would perform the primary and vital work, you have an affiliation problem before you have a pricing problem.

Scoring your firm once is useful. Scoring every pursuit against the vehicles you can realistically prime is what turns this into a habit, and that is the job of capture intelligence across your live pipeline.

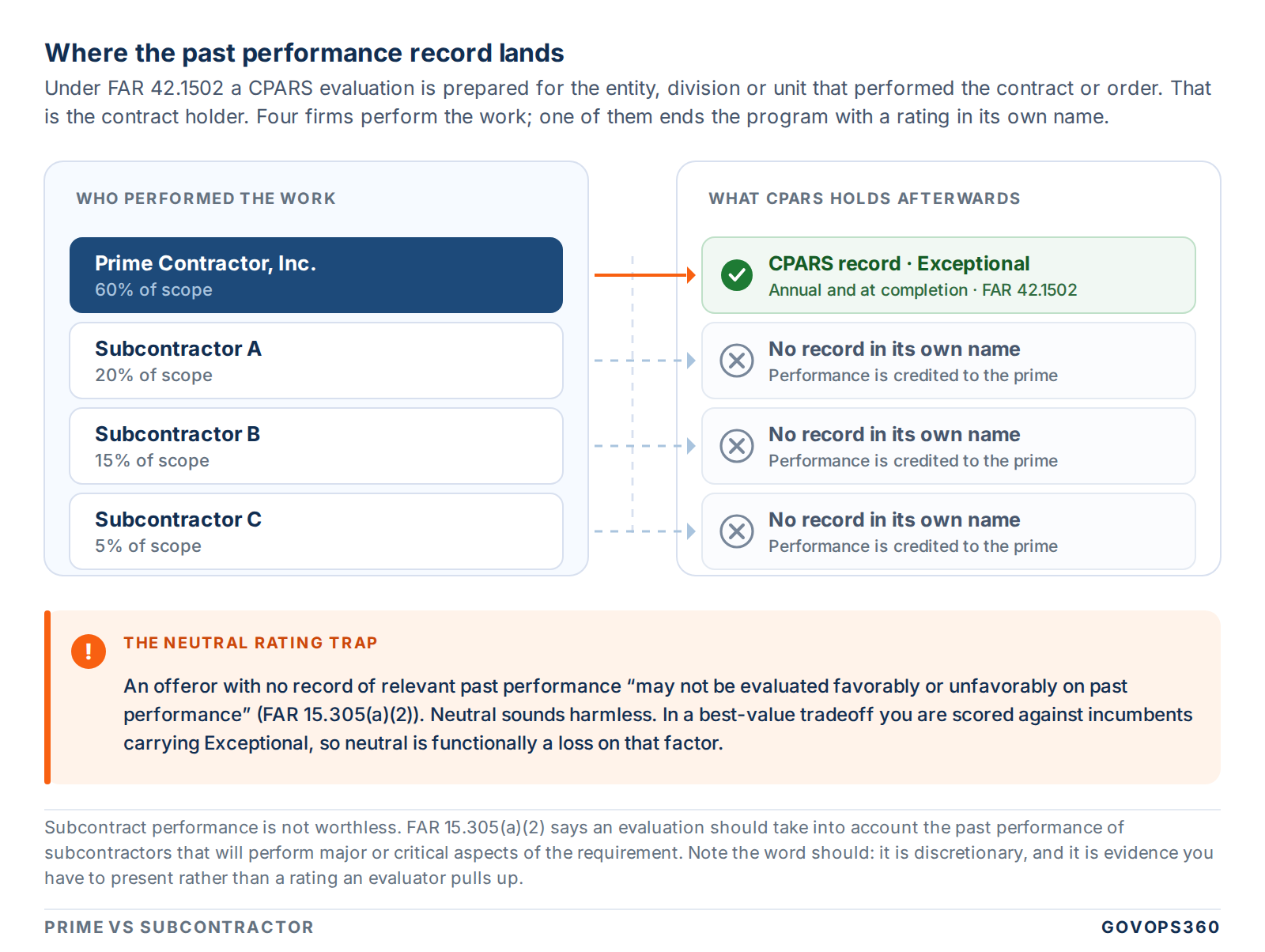

Past Performance: The Asymmetry That Decides It

Read that definition closely. The evaluation attaches to the party that performed the contract or order. That party is the prime contractor. A subcontractor can deliver flawlessly for five years across four programs and finish with no CPARS record of its own.

The consequence is more serious than most firms assume. FAR 15.305(a)(2) provides that an offeror without a record of relevant past performance “may not be evaluated favorably or unfavorably on past performance.” Neutral sounds harmless. It is not. In a best-value tradeoff you are being compared against incumbents carrying Exceptional ratings, and neutral is functionally a loss on that factor.

Comparison showing a CPARS record attaching only to the prime contractor while three subcontractors receive no record in their own name

What subcontract experience does buy you

It is not worthless, and the mechanism matters. FAR 15.305(a)(2) also says the evaluation “should take into account past performance information regarding predecessor companies, key personnel who have relevant experience, or subcontractors that will perform major or critical aspects of the requirement.”

Three things follow:

  • Note the word should. This is discretionary language, not a mandate. A solicitation can decline to credit it.
  • The credit flows when your subcontractor performs major or critical aspects. As a prime you can legitimately draw on a teammate’s record. That is what teaming is for.
  • Your own subcontract performance can be offered as relevant experience in a proposal narrative, supported by letters from the prime contractor. It is evidence, not a rating.

Put plainly: subcontracting builds a story you have to tell and defend. Priming builds a record the evaluator pulls up without asking you.

You are also rated on how you treat your subs

FAR 42.1503(b)(2)(v) makes small business subcontracting a CPARS rating factor, “including reduced or untimely payments to small business subcontractors.” Paying your subcontractors late is not just a commercial dispute. It is a documented past performance problem that follows you into the next source selection.

The Small Business Rules That Constrain the Choice

If you hold or are pursuing a set-aside, the prime-or-sub decision is partly made for you by regulation. Two rules dominate, and one of them is where compliant-looking teaming arrangements go to die.

Limitations on Subcontracting

On a services set-aside you may not pay more than 50% of what the government pays you to firms that are not similarly situated (13 CFR 125.6).

Similarly Situated

Amounts subcontracted to a firm holding the same set-aside status do not count against the limit, provided that firm performs with its own employees.

Ostensible Subcontractor

If one sub performs the primary and vital work, or you are unusually reliant on it, SBA can treat you as affiliated and you lose small status for that award (13 CFR 121.103(h)).

Mentor-Protege

A protege and mentor may joint venture as a small business for any prime contract, with the managing partner performing at least 40% of the joint venture’s work (13 CFR 125.9).

The self-performance floors

13 CFR 125.6 expresses the limits as caps on what may go to firms that are not similarly situated:

  • Services: no more than 50% to non-similarly-situated firms
  • Supplies and products: no more than 50%
  • General construction: no more than 85%, so at least 15% stays with you or similarly situated firms
  • Specialty trade construction: no more than 75%, so at least 25% stays

These apply to set-asides above the simplified acquisition threshold, including 8(a), SDVOSB, VOSB, HUBZone, WOSB and EDWOSB awards. The similarly situated carve-out is the planning lever: a small business prime can team heavily with other small businesses of the same status without breaching the limit, provided those firms perform with their own employees rather than re-subcontracting the work onward.

The trap that ends protests

The ostensible subcontractor rule is the most common way a technically compliant teaming arrangement collapses. 13 CFR 121.103(h) makes an offeror ineligible as a small business where SBA finds an ostensible subcontractor: a firm that is not similarly situated and either performs the primary and vital requirements of the contract, or is a firm the prime contractor is unusually reliant on.

Read that as a warning about proposal architecture, not just arithmetic. If your technical volume leans on a large partner’s facilities, key personnel and process maturity, you can pass the 50% calculation and still lose on affiliation. Competitors read proposals looking for exactly this, and it is decided after award, when losing is most expensive.

Most of the guides that rank for this topic do not mention this rule at all. If you build a teaming strategy from one of them, you will not see the protest coming.

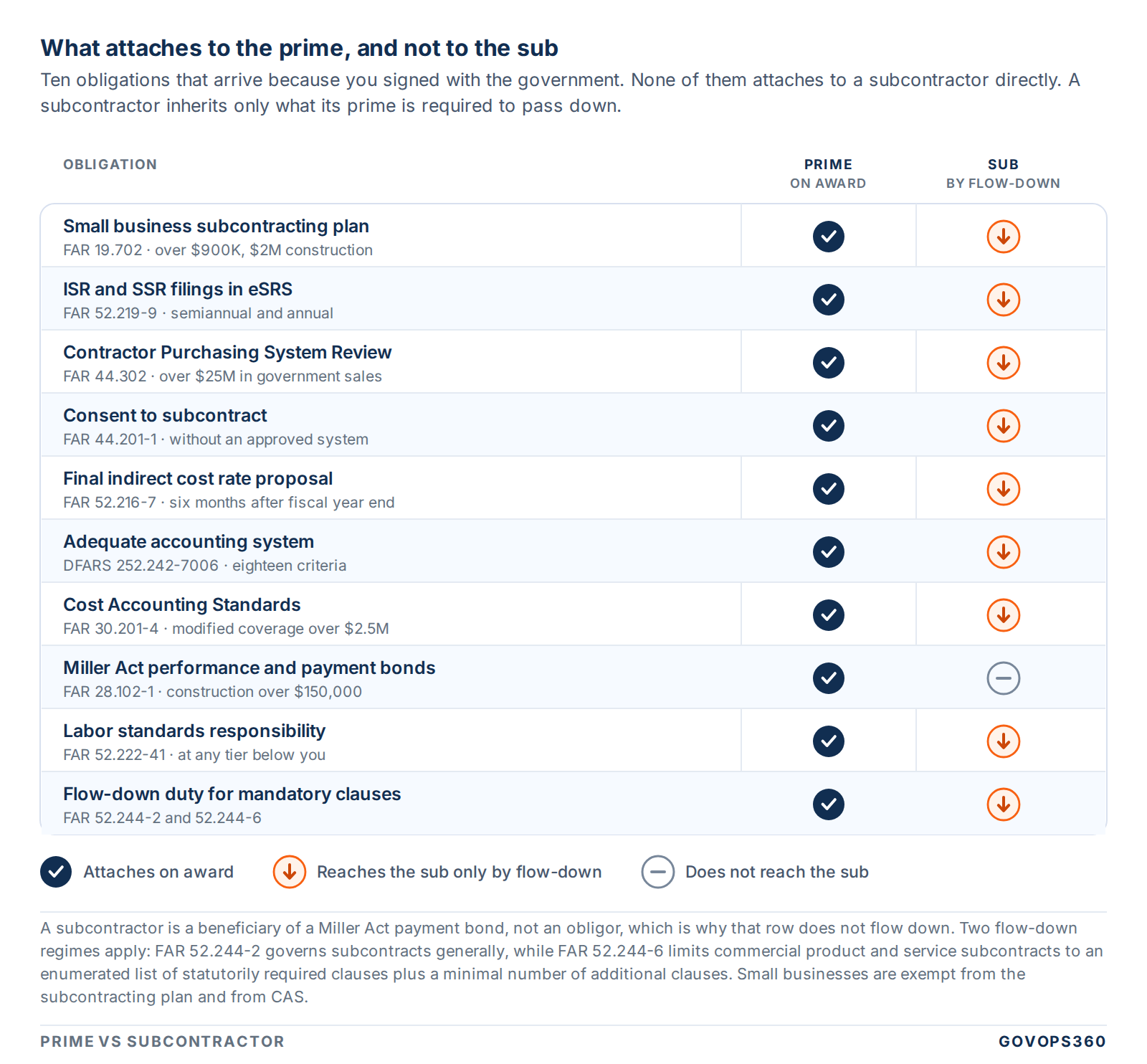

What Lands on the Prime and Not the Sub

Every item below is a system, a filing or a liability that attaches because you signed with the government. As a subcontractor you inherit only what flows down to you.

  1. Small business subcontracting plan. Required on negotiated acquisitions expected to exceed $900,000, or $2 million for construction (FAR 19.702). Small businesses are exempt. Failure to make a good faith effort is a material breach and can carry liquidated damages.
  2. ISR and SSR reporting. Under FAR 52.219-9 the Individual Subcontract Report is semiannual for periods ending 31 March and 30 September, due 30 days after close. The Summary Subcontract Report is annual, due 30 October. Both are filed in eSRS.
  3. Contractor Purchasing System Review. FAR 44.302(a) requires a review to determine whether a CPSR is needed once government sales, excluding competed fixed-price and commercial items, are expected to exceed $25 million in the next twelve months.
  4. Consent to subcontract. Without an approved purchasing system, FAR 44.201-1 requires the contracting officer’s consent for cost-reimbursement, time-and-materials and labor-hour subcontracts, and for fixed-price subcontracts above the simplified acquisition threshold or 5% of estimated cost.
  5. Final indirect cost rate proposal. FAR 52.216-7 requires an adequate submission within the six-month period following each fiscal year end on cost-type work.
  6. Adequate accounting system. DFARS 252.242-7006 sets eighteen criteria on DoD work, including segregation of direct and indirect costs and timekeeping tied to cost objectives. A material weakness finding starts a 30-day response and 45-day correction clock.
  7. Cost Accounting Standards. CAS exempts small businesses, commercial item acquisitions and contracts under $7.5 million where the business unit holds no other CAS-covered work. Modified coverage applies on negotiated contracts over $2.5 million but less than $50 million (FAR 30.201-4(b)).
  8. Bonding. Miller Act performance and payment bonds are required on construction contracts exceeding $150,000 (FAR 28.102-1(a)).
  9. Labor standards responsibility. FAR 52.222-41 requires the prime contractor to insert the Service Contract Labor Standards clause in covered subcontracts, and the contracting officer may withhold payment for violations at any contractor or subcontractor level.
  10. Flow-down duty. You are responsible for passing mandatory clauses down. Two regimes apply: FAR 52.244-2 governs subcontracts generally, while FAR 52.244-6 restricts commercial product and service subcontracts to an enumerated list of statutorily required clauses, permitting only “a minimal number of additional clauses.”

One moving part worth checking before you bid

Cybersecurity flow-down is in flux. On 13 July 2026 the Department announced an immediate suspension of CMMC Phase II requirements, which had been scheduled to begin on 10 November 2026, while a comprehensive review proceeds. Phase I self-assessment requirements remain in place. Where the DFARS 252.204-7012 clause applies, paragraph (m) still requires it to be flowed down without alteration to subcontracts involving covered defense information, including subcontracts for commercial products and services.

Confirm the current position before relying on any of this in a bid. This area has moved twice in a year.

Table of ten compliance obligations that attach to a prime contractor on award and reach a subcontractor only by flow-down

Margins, Cash Flow and the Payment Lag

Why prime margins are higher

There is no published federal statistic comparing prime and subcontract margins. DCAA does not release one, SBA does not, and GAO does not. Anyone quoting you a precise differential is quoting a rule of thumb, and you should treat it as one.

The reasons primes earn more are structural, and they are checkable:

  • The prime carries performance risk for the entire scope, including work it did not perform itself. Risk is compensated.
  • The prime applies G&A, and where it exists a subcontract handling pool, to subcontracted dollars. It earns on volume it passes through.
  • The prime holds the customer relationship, which compounds into recompete advantage that a subcontractor cannot bank.

The cash flow trap

Priming changes when money moves, not only how much of it you keep.

The agency owes you payment on the later of 30 days after a proper invoice or 30 days after acceptance (FAR 32.904(b)). On construction progress payments the clock is 14 days.

Your obligations to your subcontractors do not wait for that. On construction contracts the Prompt Payment Act requires the prime contractor to pay subcontractors within seven days of receiving payment from the agency, and retainage may be withheld only where the subcontract permits it, written notice of the deficiency is given, and the government receives a copy of that notice. Separately, where FAR 52.232-40 applies, a prime contractor receiving accelerated payments must pass accelerated payments to its small business subcontractors within 15 days, without charging them a fee, and must flow that obligation down.

So a prime contractor running a subcontractor-heavy program is financing the gap between its own receivables and its payables. That is a working capital requirement, not an accounting detail, and it is the item most commonly missing from a firm’s first prime bid. Getting paid on time starts with a proper invoice, which is why quoting and invoicing discipline is a cash-flow control and not just admin.

Fee is not where you recover a bad structure

On time-and-materials work your rates are fixed at award for the life of the vehicle. On firm-fixed-price work the entire cost risk is yours. Neither gives you a lever to fix an underpriced bid later. If the only way a prime contractor bid closes is by cutting fee, the honest read is that you should be teaming on that pursuit instead.

Building those rates correctly is its own discipline. Our guide to the wrap rate formula and benchmark ranges walks through the cascade and ships a free calculator.

Conclusion

The prime-or-sub question is usually asked as a matter of ambition. It is better treated as a matter of readiness, pursuit by pursuit.

Subcontracting is not a lesser path. It builds capability, revenue and relationships, and for a firm without an adequate accounting system or the working capital to finance a payment lag it is the correct commercial answer. What it does not build is a CPARS record, and that is the asset a source selection reads first.

So the sequence that works is deliberate. Subcontract to build capability. Fix the systems the scorecard exposes. Then prime on pursuits where your past performance is genuinely relevant and your teaming structure survives the ostensible subcontractor test.

Run the scorecard above against your firm as it exists today, not as you intend it to look by the time of award. If you score below five, the most valuable thing you can do this quarter is close a gap rather than submit a bid.

Know Which Pursuits You Can Prime

See how GovOps360 tracks vehicle-by-vehicle readiness, teaming structures and subcontracting plan obligations against your live pipeline.

Frequently Asked Questions

1. What is the difference between a prime contractor and a subcontractor?

A prime contractor holds the contract directly with the government and has privity of contract with the agency. A subcontractor holds a contract with the prime and has no direct contractual relationship with the government. That single difference drives everything else: the prime is paid by the agency, is evaluated in CPARS, carries performance risk for the whole scope, and is responsible for flowing mandatory clauses down to its subcontractors. FAR 44.101 defines subcontractor, while the FAR notably contains no discrete definition of prime contractor.

2. What is a prime contract?

A prime contract is the agreement signed directly between a federal agency and a contractor to deliver supplies or services. It is the instrument that creates privity with the government, obliges the agency to pay under the Prompt Payment Act, and makes the contractor accountable for the entire scope of work, including anything performed by subcontractors beneath it. Every subcontract exists to support performance of a prime contract.

3. Does subcontracting count as past performance for a prime bid?

Partly, and less than most firms expect. Subcontractors do not receive their own CPARS record, because under FAR 42.1502 the evaluation is prepared for the entity that performed the contract or order, which is the prime. Subcontract experience can be offered as relevant experience in a proposal narrative, and FAR 15.305(a)(2) says evaluators should take into account the past performance of subcontractors performing major or critical aspects of a requirement. But note the word should: it is discretionary, and it is evidence rather than a rating.

4. How much of a contract must a small business prime perform itself?

Under 13 CFR 125.6, on a services set-aside above the simplified acquisition threshold a small business prime may not pay more than 50% of the amount it receives from the government to firms that are not similarly situated. The cap is 85% for general construction, so at least 15% stays in-house, and 75% for specialty trade construction, so at least 25% stays. Work subcontracted to a similarly situated entity, meaning a firm with the same set-aside status that performs with its own employees, does not count against the limit.

5. Can a subcontractor get its own CPARS rating?

No. CPARS evaluations attach to the holder of the contract or order, so subcontract performance is recorded against the prime rather than the subcontractor. A subcontractor can ask the prime for a performance letter and can cite the work as relevant experience in future proposals, but there is no government-held rating in its own name. This is the strongest structural argument for eventually moving to prime work.

6. Is it better to be a prime contractor or a subcontractor?

Neither is better in the abstract. Priming carries higher margin, direct agency relationships and a CPARS record, in exchange for full performance risk, a substantial compliance load and the working capital to finance the gap between agency payments and subcontractor payments. Subcontracting carries lower margin and no CPARS record, but far lighter compliance and much less risk. The right answer is decided per pursuit by whether your firm currently has the systems, capital and relevant past performance to perform as a prime.

7. Can a small business be treated as large because of who it subcontracts to?
